Symptom
This documentation provides insights of the duration calculation logic in the Production Execution Duration app (ID: F2172)
Image/data in this KBA is from SAP internal systems, sample data, or demo systems. Any resemblance to real data is purely coincidental.
Environment
SAP S/4HANA Cloud Public Edition
Cause
The Production Execution Duration analytical app is a comparison of planned and actual (confirmed) durations in the Production Order as deviation, in total and in %.
Resolution
All the calculations in the Production Execution Duration app are performed with the lowest useful unit of measure for durations, the second. This gives the best result as it needs to be rounded up or down only once. Later the result is transferred to a more comfortable unit of measure.
Thus, in the app the duration can be seen in two units of measures:
- In seconds (which has a rather high value in most cases)
- And a more suitable one
This conversion is done hard-coded as follows:
case
when ddis.ActualWorkdayDurnInSeconds < 60 then cast('S' as actualdurationunit)
when ddis.ActualWorkdayDurnInSeconds < 3600 then cast('MIN' as actualdurationunit)
when ddis.ActualWorkdayDurnInSeconds < 86400 then cast('STD' as actualdurationunit)
when ddis.ActualWorkdayDurnInSeconds < 604800 then cast('TAG' as actualdurationunit)
when ddis.ActualWorkdayDurnInSeconds < 2592000 then cast('WCH' as actualdurationunit)
when ddis.ActualWorkdayDurnInSeconds < 31536000 then cast('MON' as actualdurationunit)
else cast('JHR' as actualdurationunit)
In some cases this may lead to different units for the planned and the actual duration, for example if there is a bigger difference, like the planned duration is 3000 seconds but the actual is 7200 seconds. Then the apps displays 50 MIN for the planned duration but 2 HRS for the actual one.
This is in order to avoid a zero (0) before the decimal point.

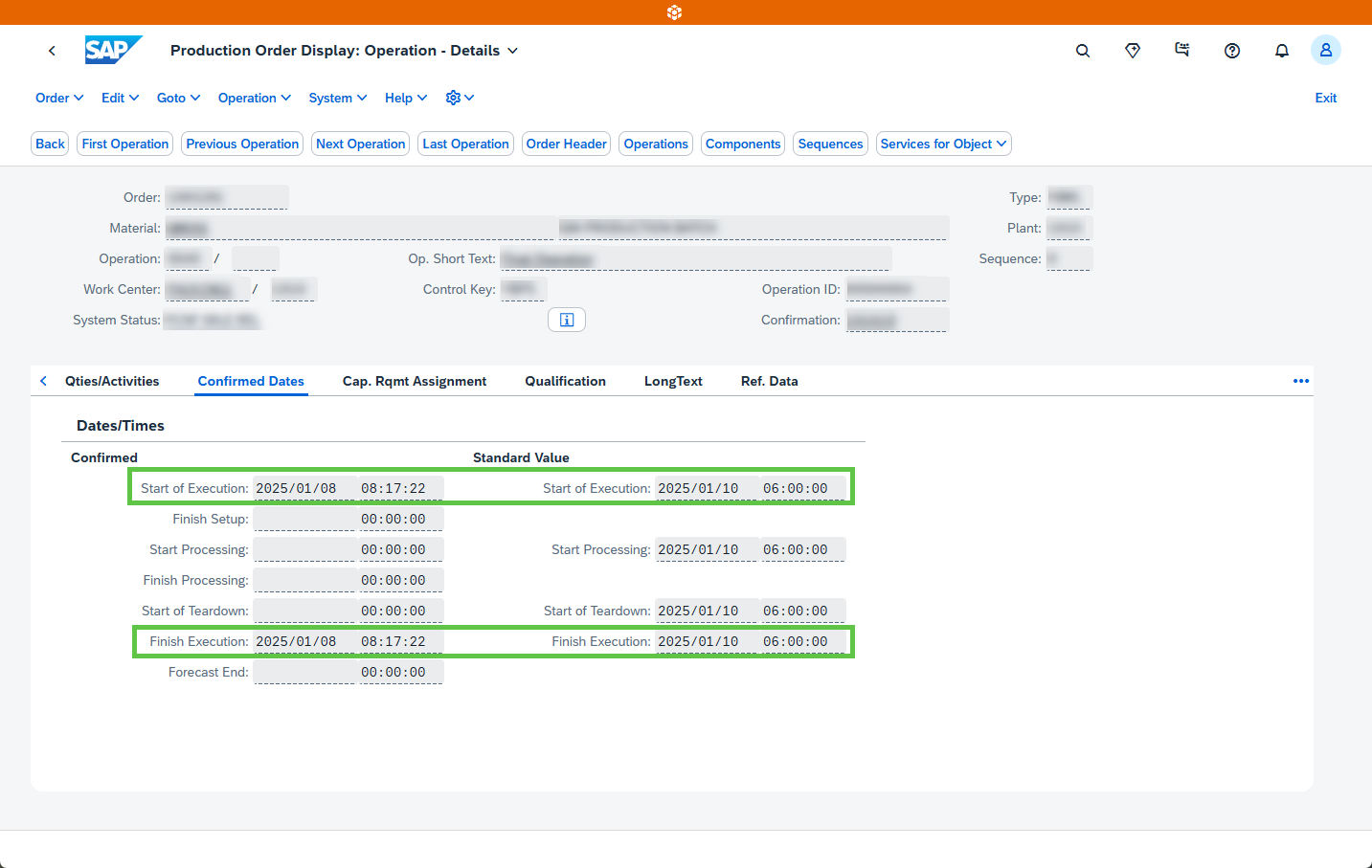

The duration calculation is based on the factory calendar, therefore a weekend or a holiday is considered if it lays between a start and an end date.
